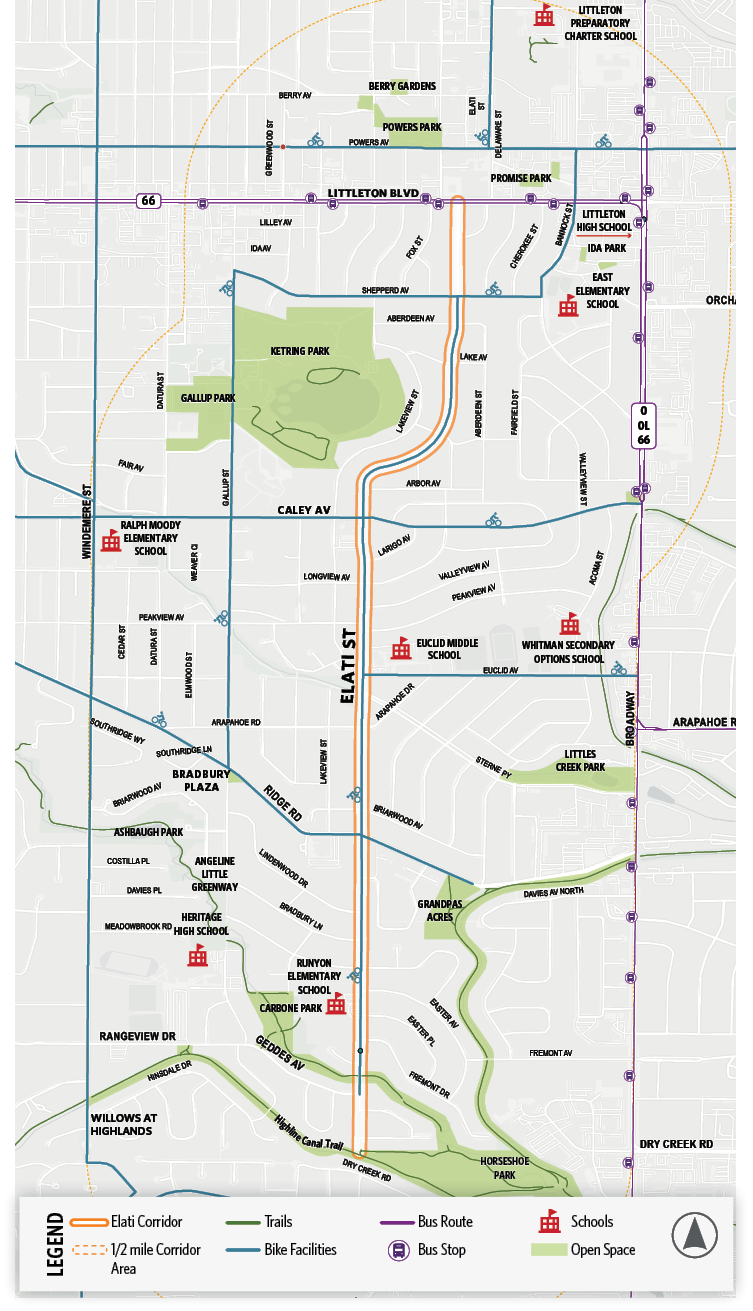

The Elati Street Corridor Study is focused on creating an actionable vision and plan to transform the corridor into one that prioritizes safety and comfort for all users. Littleton has three distinct paths forward, ranging from targeted near-term safety fixes to full corridor reconstruction. These approaches are not competing alternatives. They are intended to be sequenced, beginning with what is achievable now and building toward the complete vision. The draft Implementation & Next Steps chapter(PDF, 983KB) provides additional detail on these approaches, including key tradeoffs, a phased implementation strategy, potential funding sources, and recommended next steps; a summary of this information is also provided below.
From the Shared Path Corridor preferred option, the project team has identified the following implementation options (A, B, and C). Staff is scheduled to present the three options to Littleton City Council on September 1, 2026.
Option A: Traffic Calming Only
Option A addresses Elati Street's most urgent safety deficiencies through intersection improvements and speed reduction measures that can proceed with available funding, without right-of-way (ROW) reallocation or reconstruction.
Key changes include
- Speed cushions at mid-block locations in each corridor segment.
- Raised crosswalks at key pedestrian crossing locations and school zones.
- Raised intersection at Euclid Avenue.
- Rectangular Rapid Flashing Beacons (RRFBs) at trail and priority crossings.
- Curb extensions (bulb-outs) to reduce crossing distances, slow turning movements, and daylight parking setbacks at intersections to improve pedestrian visibility.
- Directional ADA-compliant curb ramps at all upgraded crossings.
- Removal of the existing traffic circles, with alternative traffic calming to be installed at applicable locations.
Key considerations
- No sidewalk changes will occur within Option A. Sidewalk widening is technically compatible but requires expanding into City ROW adjacent to private front yards. Any widening would require individual property owner coordination and may trigger easement work. This does not prevent implementation, but it adds complexity and cost beyond typical traffic calming.
- Coordination with Littleton Public Schools (LPS) will occur during the design phase to reconfigure the circulation at Runyon Elementary School.
- No impacts to existing ROW, landscaping, or trees. All improvements will occur within the existing pavement width.
- Improvements could occur along the entirety of the corridor, from Littleton Boulevard to the High Line Canal.
- Implementation will be coordinated with the 2028 pavement project and can be funded through existing budgets.
- Option A leverages existing traffic-calming tools defined in the Littleton Traffic Calming Toolbox (PDF).
Option B: Traffic Calming Plus Shared Space Retrofit
Option B adds a restriped, physically buffered shared-use space on the west side of the corridor, timed to coordinate with the City's planned 2028 pavement resurfacing. Rather than rebuilding the street, this approach reallocates the existing pavement footprint, converting one parking lane into a protected pedestrian and bicycle shared space, while retaining all Option A traffic calming elements.
Key changes include
- Restriping of the west side for a 10 to 12 foot protected shared pedestrian and bicycle space.
- Physical buffer between the shared path and travel lane using vertical separation materials (subject to community material preference).
- Parking consolidated to the east side; an estimated 70 percent of existing spaces on the east side are retained.
- Shared space implemented south of Caley Avenue where pavement width allows.
- Coordination with the 2028 pavement project reduces cost and disruption.
Key considerations
- Option B does not widen existing sidewalks. The west-side shared space functionally serves pedestrians and bicyclists on that side. If east-side sidewalk widening is desired, the same ROW considerations apply as under Option A.
- Coordination with LPS will occur during the design phase to reconfigure the circulation at Runyon Elementary School.
- Parking considerations will occur through design and property owner coordination.
- No impacts to existing ROW, landscaping, or trees. All improvements will occur within the existing pavement width.
- Improvements would only occur south of Caley Avenue to the High Line Canal.
- Implementation will be coordinated with the 2028 pavement project and can be funded through existing budgets.
Option C: Full Corridor Reconstruction
Option C is the complete, long-term vision: a full rebuild that delivers the permanent Shared Path Corridor. This is the highest-cost approach, dependent on major capital funding, but it produces the most durable and highest-quality outcome and creates the best conditions for addressing ROW constraints systematically.
Key changes include
- Full roadway reconstruction with 10-foot travel lanes.
- A 10 to 12 foot continuous shared-use path on the west side with a 4 to 6 foot landscaped buffer.
- A 5 to 6 foot ADA-compliant sidewalk on the east side.
- All Option A traffic calming treatments built to permanent standards.
- Permanent curb line adjustments and new curb ramps throughout.
- Raised intersections at all major cross streets.
- East-side sidewalk widening evaluated segment by segment; constrained areas require property owner coordination.
Key considerations
- Dependent on funding; likely a 10-plus year timeline to secure grants or debt financing.
- Parking considerations will occur through design and property owner coordination.
Summary
Comparison of implementation options by cost, timing, and key considerations
| Implementation option |
Cost |
Timing |
Key considerations |
| A: Traffic Calming |
$ (1 of 4, lowest) |
1 to 3 years |
- To be coordinated with the 2028 pavement project.
- Leverages existing traffic-calming tools.
- Could cover the full corridor from Littleton Boulevard to the High Line Canal.
- No impacts to existing ROW, landscaping, or trees.
|
| B: Retrofit plus Option A |
$$ (2 of 4) |
1 to 3 years |
- To be coordinated with the 2028 pavement project.
- Parking considerations to be worked through with design and property owner coordination.
- Would cover Elati Street south of Caley Avenue to the High Line Canal.
- No impacts to existing ROW, landscaping, or trees.
|
| C: Reconstruction |
$$$$ (4 of 4, highest) |
10-plus years |
- Dependent on funding.
- Parking considerations to be worked through with design and property owner coordination.
- Covers the full corridor from Littleton Boulevard to the High Line Canal.
|
